Follow these steps to Add and/or Edit Scheduled Events
- Go to the Scheduler via the menu tab on left side of main screen and click on ‘Schedule List’
- This will open Schedule List - Filters in header can be used to filter list
- Click ‘Add New’ located in the upper right corner on the ‘Schedule List’ Bar
- Enter ‘Name’
- Select ‘Dispatch Type’
- Enter ‘Comments’
- Select ‘Trade’
- Select 'Do Event Shadowing' Event Shadowing Support Page
- Enter ‘Estimated Hours’ This is captured for each interval type with shadowing feature
- Select ‘Owner(s)’ – This is not typically done unless schedule is done by same person every time

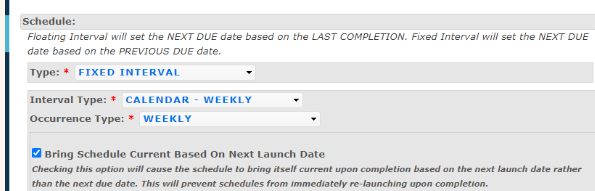

- Select ‘Schedule Type’
- One Time Event = Not repeating
- Fixed Interval = Same frequency regardless when last complete (example: monthly PM due 20th of month will be due every month on the 20th regardless of last time complete)
- Floating Interval = Frequency will float based on last time complete (example: monthly PM is complete 5 days after due date 20th of month, PM will launch next month 5 days after previous month or 25th of month, this can reduce waste of activities being done to frequently)
Note: If scheduled event is not complete before next schedule system will not launch a duplicate event. If event is completed after next schedule would have been due system will account for both events being complete.
- Select (Occurrence) Interval type – Days, Hours, Cycles, Calendar Monthly, Calendar Weekly, Calendar Daily, Calendar Yearly.
- On calendar daily you can add the shift you want this schedule to launch.
- Note if you add the shift to the calendar daily schedule, this will set the next launch date/time as the shift start time and the next due date/time will be the end of shift time. this is automatically set. You can change the next scheduled time during that shift if needed.
- Note: Annual cycles are on a 12 month interval. Monthly is defined by the same day each month.
- On calendar daily you can add the shift you want this schedule to launch.
- Multiple types can be selected (example: you could schedule the Monthly and Yearly PM from a single scheduler. To do this you will need to identify which steps to perform Monthly vs. Yearly in single PM document, or link both Monthly & Yearly PM Documents to the schedule. When schedule launches it will display the schedule type ‘Monthly or Yearly’ in schedule header)
- Day – Select if you’d prefer launch on same day of Week or Month every time it launches
- Enter ‘Schedule Dates’
- Launch Date – This is the initial date on which the schedule will launch Dispatch event
- Due Date – This is the initial due date following launch date. The idea is to launch event with enough time prior to Due date to ensure success (example: Yearly PM you may want to Launch a couple weeks prior to due date to allow for planning)

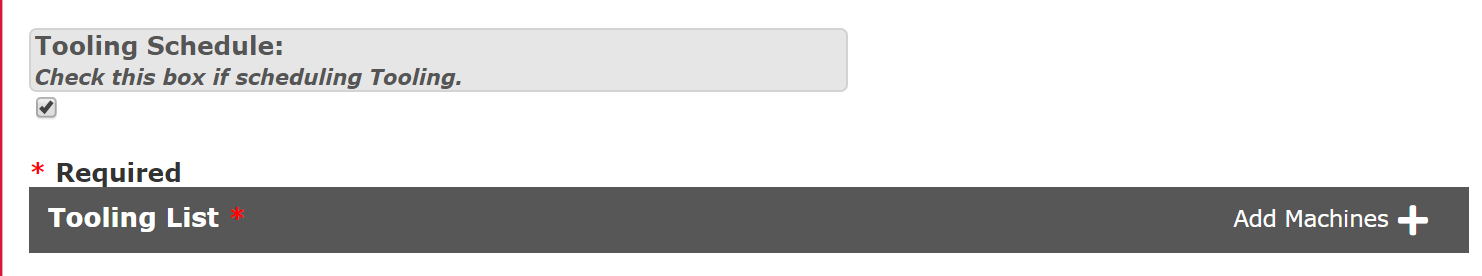

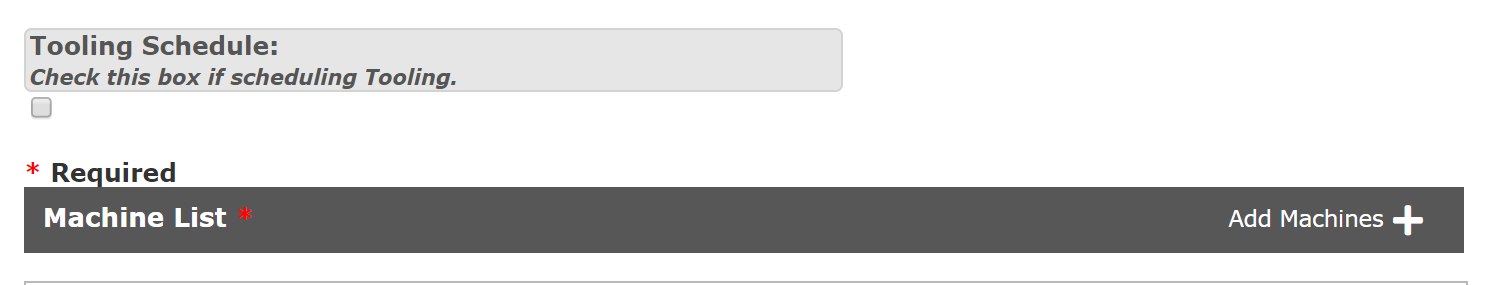

Note: Launch to Due Date interval will remain consistent unless edited from this screen - Select applicable machine(s). Use filter on right hand side to filter machine list
- Click ‘Save’ or ‘Save And Add Document(s)’
- Save And Add Document(s) will take you to documents list where you can select applicable document(s) to associate to schedule
- Select Documents and Click ‘Save’
- Note: You'll need to save the schedule before you can add a BOM Kit or the estimated resource hours by trade. Simply click 'add' to put in a trade and estimated labor time for that schedule. For more on the Spares Kitting this article.
