Non Production Time Reallocation Tool

Last updated: June 19, 2026

Why?

It is extremely difficult to reallocate Planned Production time to Planned Non-Production time (aka Planned Downtime, Planned Idle time).

If you consider training, company meetings, fire drills, etc. as Planned Non-Production time. These events cannot be planned using pitch templates because they do not follow a predictable pattern, but they happen frequently enough that a simple approach is needed in order to maintain accurate metrics.

What?

We've created a Reallocation Tool that lives on the Production Schedule page that will create a closed dispatch, that moves the planned production time to planned non production time and in turn adjusts your LMPU metric accordingly.

How?

L2L Support can enable a Site Setting for you.

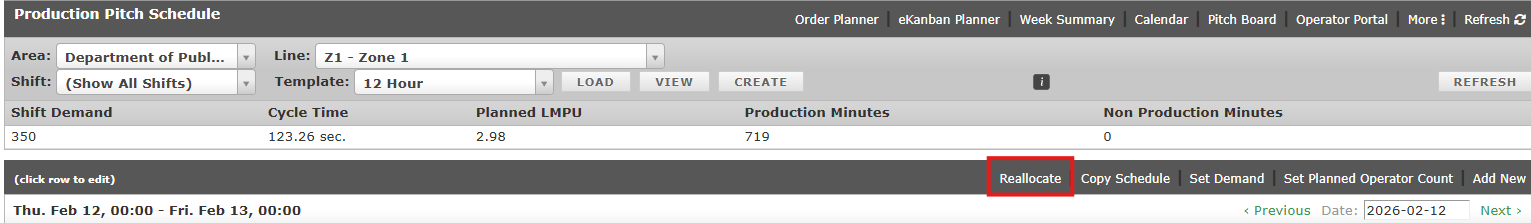

  1. From the Operator Portal (or the Production Menu), click More > Schedule.
  2. In the Schedule, click 'Reallocate'.

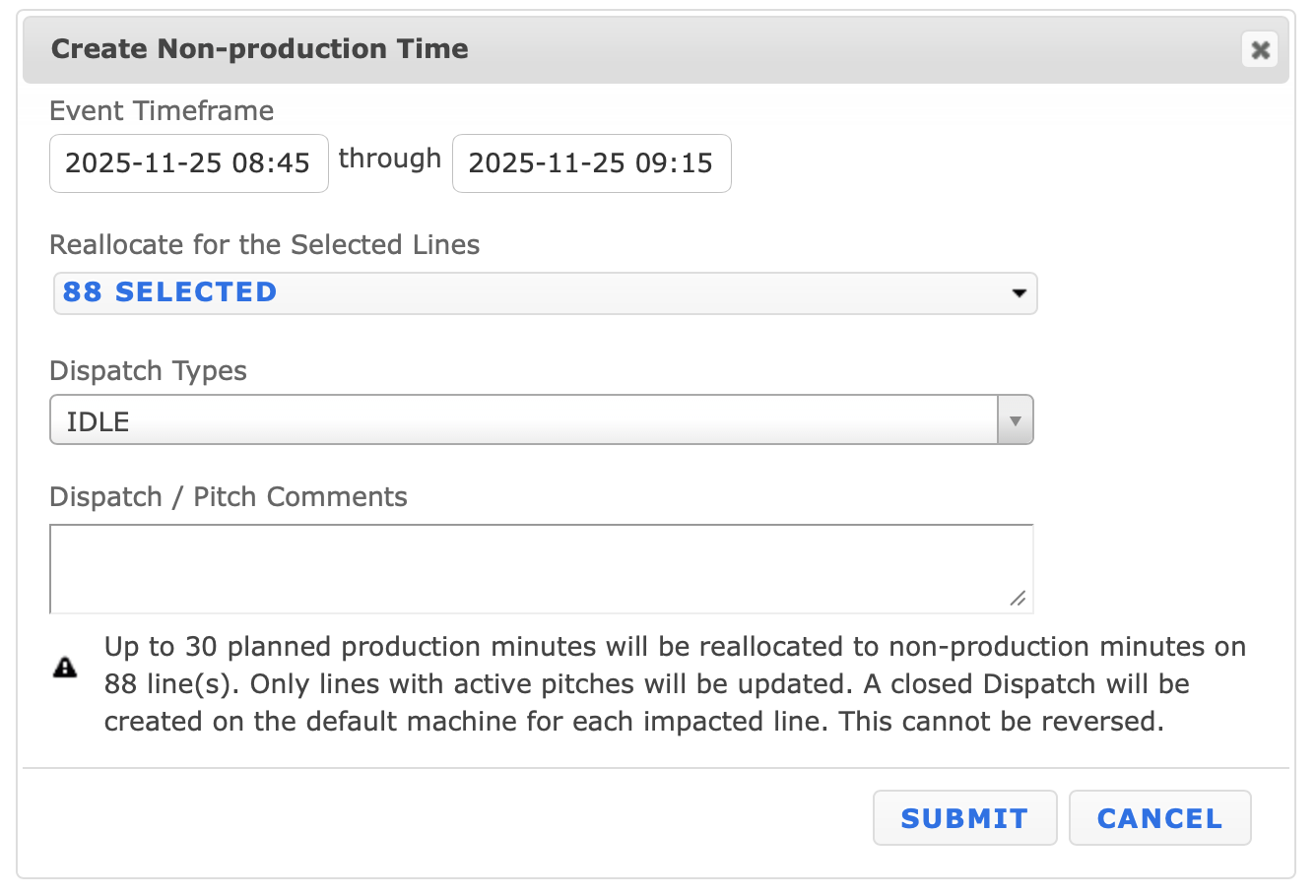

  1. Select the desired timeframe (when the event occurred).
  2. Choose the impacted Lines in that Area. (will only show lines within the area)
  3. Select a Dispatch Type to attribute the event to. Note: Cannot be a Down Dispatch Type).
  4. Enter in comments you'd like appended to those dispatches (optional). You will see a warning at the bottom of the comments, and it will calculate the minutes at the bottom.
  5. Submit.

Notes:

  • You will need Planner Permissions in the production settings.
  • The change to the Production/Non-Production Minutes. Your LMPU metric will also be adjusted to account for the change in minutes.
  • If you had planned non-production minutes, this will add to them.



FAQs & Troubleshooting:

  1. The tool creates closed dispatches; no down dispatch types can be used.
  2. Dispatches are always associated to the default machine on the line.
  3. This tool is preferred over the two Planned Downtime Dispatch Type settings as it provides a faster, universal update to all production metrics utilizing planned production minutes—eliminating the need to launch individual dispatches.
  4. Warning: Actions performed with this tool are irreversible. Verify all data carefully prior to submission.
  5. A single event cannot exceed 24 hours. For downtime spanning longer than 24 hours, the reallocation tool must be executed multiple times to cover the full duration.
  6. To ensure data integrity, events cannot be backdated more than 72 hours from the current time. Please plan accordingly to address updates within this window.
  7. Other relevant articles:
    1. Planned Downtime - Exclude from Availability Production Metric
    2. ?Setup - Dispatch Types
  8. Tip: For tracking purposes, we suggest you create a specific non-impacting dispatch type i.e. Reallocation Time," and run a dispatch history report to see who reallocates time.
